    Automated calculation of job sequence numbers and separating visualization and planning horizons

    Jan Viergutz
    January 14, 2024

    We are excited to announce the release of the latest version of our production scheduling software just plan it (jpi in short), specifically designed for high-mix low-volume manufacturers. This new version incorporates a range of powerful features that will greatly enhance your ability to efficiently manage and organize your production schedule. Let's take a look at what's new and how it can benefit your manufacturing operations.

    One of the most impactful decisions a planner makes when working with jpi, is to determine the priority for each job. The job sequence number is a core parameter for the automatic finite scheduling engine when assigning the operations to the requested resource(s). Before today, it was the planners' task to manually define the sequence number for each job. In this context, it was understandable to us that this manual task to get everything to where it belongs can be very time-consuming, especially with schedules with many jobs. Accordingly, we have repeatedly received suggestions from our customers to be able to assign the job sequence numbers automatically.

    And now the time has finally come: with the current release, jpi offers the option of automatically assigning job sequence numbers based on customizable rules.

    Automated calculation of job sequence numbers

    The idea of the automated calculation of job sequence numbers is to provide extended functionality in addition to the critical sequence number

    • to help to achieve better overall scheduling results (compared to the manual process) and
    • to easily integrate multiple new jobs into the schedule with little effort

    Accordingly, the new functionality allows you to

    • automatically calculate sequence numbers for all selected jobs,
    • based on customizable, KPI-based rules and
    • recalculate your entire schedule with the click of a button.

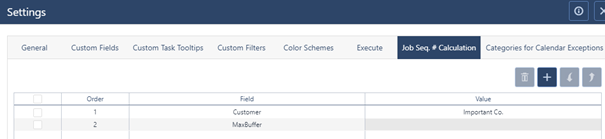

    In this regard, the initial step of making use of the new functionality is to activate it. This can easily be done by defining the set-up of criteria for the automated job sequence number calculation. In the settings dialog, you will find a new tab” Job Seq. # Calculation”:

    Settings Job Seq # Calculation

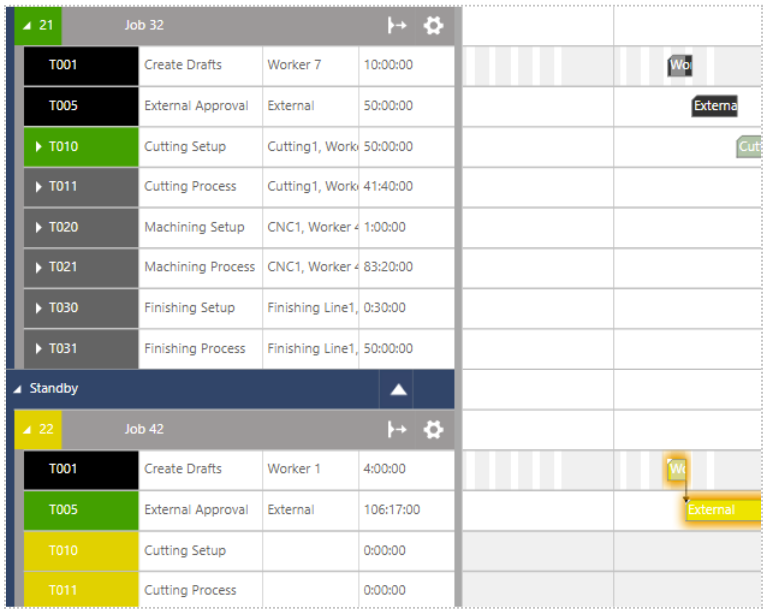

    Here you can define the rules the engine will apply when processing an automated job sequence number calculation scheduling run. With setting one or multiple order lines the functionality is directly activated. Let’s run through a short explanation of the options you have:

    1. DueDate: Your job sequence numbers will be sorted by their due date in ascending order, meaning the job with the earliest due date gets the highest priority. Jobs without a due date will be sorted to the bottom of your sequence.

    2. BufferLevel: Your job sequence numbers will be sorted by their BufferLevel (more about buffer level in this blog post). Note: the BufferLevel of a job is always not independent but related to your current schedule. Hence you can go through iterations, as with each new scheduling result the buffers will change. Jobs without a due date and therefore without a buffer will be sorted to the bottom of your sequence.

    3. MaxBuffer: this is a new metric. This describes the (theoretical) maximum buffer that you would realize when having resources with infinite capacity. Note: the MaxBuffer of each job is independent of a given scheduling result (and only changes on approval of shopfloor data that moves the planning start). Hence iterations of recalculating job sequence numbers of the same schedule are not needed as it makes no sense.

    4. JobStatus/Customer/Job Customfields: You can enter a specific value here. If the given field matches the selected value exactly, the given jobs will be prioritized higher. Use this to mark important jobs or highly prioritized customers to make sure their orders are treated as such.

    When setting up your criteria you can combine as many of the above options as you would like. As an example, the order column in the picture above determines the general order of calculation of the job sequence numbers. So, in the first iteration, the “Field” with “Order” 1 is taken into consideration, then, if there are jobs with the same values after iteration one, the second “Order” becomes effective for the second iteration, and so on.

    To trigger the automated calculation of job sequence numbers, you will find a new button in the “Update” tab in the “Schedule” section (see the icon at the very right below):

    update

    Please note:

    • a “normal” scheduling run (both triggered automatically or manually) does not include the automated job sequence number calculation
    • with every trigger of the automated calculation of job sequence numbers, you always trigger a full scheduling run as well.

    If you generally want to use the automatic sequence number assignment but would like to exclude some special jobs from the algorithm, then we also offer the corresponding option.

    When excluding a job from the automatic assignment, it will be pinned to its current sequence number. This means for example a job pinned to sequence number 5 will keep that even after using the automatic sequence number assignment. This does NOT mean that the job is guaranteed to be scheduled to the same time slots, as due to the new sequence number assignments of other jobs than plan could have shifted.

    You can in/exclude specific jobs from the automated calculation in a couple of ways:

    • You can do so in the context menu of a given job by selecting Ex/Include Seq.# Calculation

    Context menu

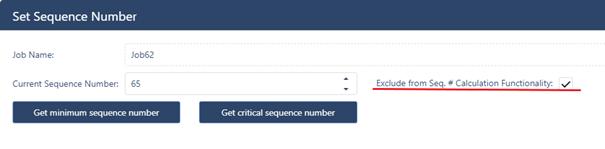

    • You can also decide to do so when using the Sequence Number dialog

    set sequence number

    • Additionally, when using drag&drop to manually change the sequence numbers, the dropped job will automatically be excluded from the automated recalculation.

    You can see which jobs are excluded at a glance in the job view by looking at the sequence number:

    excluded jobs

    Excluded jobs will have this pin symbol to notify that they will be kept at this sequence number regardless of changes around them via the automatic sequence calculation.

    As part of the development and testing of the new functionality, we took a lot of time to derive instructions for the best possible use. As usual in HMLV scheduling, there is no one golden rule here, but each use case must be considered individually and carefully. But we can still give guidelines for two typical cases.

    1. If you have a solid plan already, meaning you do not have to catch up to a lot of already late jobs and can focus on the future, as well as have a couple of degrees of freedom in your processes, so you do not have multiple strict bottlenecks that clock up your production, then using the MaxBuffer criteria will help you best to keep things in order and quickly assign new jobs to their place in the plan.

    2. If you are fairly restricted by your bottlenecks, this means the scheduling engine can’t try to spread out the load, and ordering tasks on the bottleneck is more important. In this case, our testing showed, that using a couple of iterations of the BufferLevel criteria is most helpful.

    We will go into more detail and tips and tricks on how to best use this in the upcoming webinar as well as future blog posts. As the usage of this mighty functionality provides the potential to achieve great benefits, we highly recommend you make intensive use of all the resources we provide.

    We presented the new functions in a webinar on January 23, 2024. Watch the recording here

    Separating planning and visualization horizon for performance gain and improved focus

    Most of our users have production orders coming in weekly if not daily, some of which are very important short-term orders, and others have due dates many months in the future. Until today, jpi handled both cases exactly the same. We schedule the jobs in accordance with the rest of your schedule and show both to your planner with the same level of detail.

    For just a few orders, that might be fine. But if we scale this up, we overload the planner with a lot of job information that is simply not important RIGHT NOW. To help keep a better focus we are introducing a new feature to jpi we call the “Visualization Horizon”.

    While all jobs are still going to be fully planned, we will only add bars to your planning board for tasks that fall into your visualization horizon. This means that while you have your schedule calculated for the next 52 weeks, you can have your planner focus on solving important scheduling challenges happening in the next 4 weeks.

    All reports and dialogs will of course still contain ALL information in your schedule, but the graphical interface will simply just show you your immediate workload. As the performance of each software with a graphical interface is also determined by “painting” what needs to be shown, you will improve the performance of your jpi account the more you reduce your visualization horizon.

    You can define the "Visualization Horizon" in the “General Settings” dialog, independently from the planning horizon, with its minimum being 1 week and the maximum visualization horizon equalling the planning horizon.

    Settings Visualization Horizon

    In case a job or parts of a job fall out of the visualization horizon, just plan it

    • won´t show any respective bar in the Gantt views but
    • does show the scheduling results such as scheduled start and end date when expanding the respective job in the job view.
    • You can also see a symbol for the tasks affected on the left.

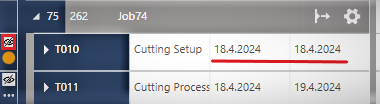

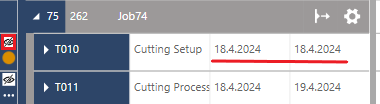

    Visualization Horizon in the Gantt views

    In summary, we recommend thinking about what time window requires your immediate focus in terms of the Gantt chart views of the main client! Focus on gaining performance wins!

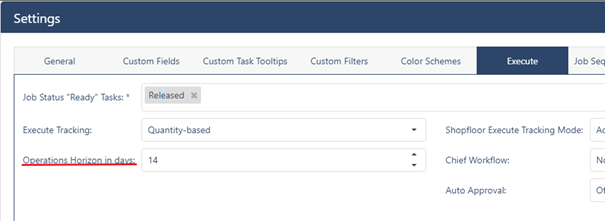

    But this functionality is not only available for the main client. You can also reduce the focus of the tablet client (and the operator client) accordingly. Here just switch to the tab “Execution” in the settings dialogue and adjust the "Operations Horizon" accordingly.

    Settings Operations Horizon

    Please Note: the setting for the Execute Mode is in days not weeks.

    We are convinced that reducing the horizon here certainly makes sense in pretty much all cases. Experience shows that the workers on the shop floor have a much shorter horizon. Here it is certainly enough to show the work list for the next (maximum two to three) weeks.

    Additional enhancements

    In addition to the above-mentioned features, we added a couple of minor enhancements to jpi with this release:

    • Redesign of the Calendar Exception dialog, added functionality to allow selection of Resource Groups
    • Added Job Strategy to Job Templates with the following options:
      • Not Set (default behaves the same as now, the Job Template does not enforce a strategy and no template binding is lost if a job changes its strategy
      • ASAP: the Template enforces jobs based on it to be scheduled ASAP, template binding is lost on a change in the job
      • JIT: the Template enforces jobs based on it to be scheduled JIT, template binding is lost on a change in the job
    • Added the option to change the sequence number of all relevant objects (Resources, Resource Groups, Jobs) to all dialogs

    Finally: this release also includes a lot of bugfixes and smaller performance changes, as well as major internal changes that are setting us up for even more improvements in the future!

    That’s it for today. We hope you all had a nice holiday time and are excited to get started with more improvements to come to JPI in the new year! If you have ideas for future enhancements that would help you schedule even better with JPI let us know!

    As always, we are happy and eager to receive any feedback from you guys and to answer any questions you may have.

    Until then,

    Happy Scheduling!
