    Using ASAP Plus and JIT Plus to reduce waiting between operations

    November 5, 2024

    Scheduling work as early as possible can leave it waiting before a busy downstream resource. Scheduling backward from a due date can reduce early starts, but may leave limited room for disruption.

    ASAP+ and JIT+ in Just Plan It combine forward and backward scheduling to reduce avoidable gaps between operations. These extended strategies help planners refine job timing while respecting the capacity, dependencies, and priorities represented in the schedule.



    Understand the two calculation sequences

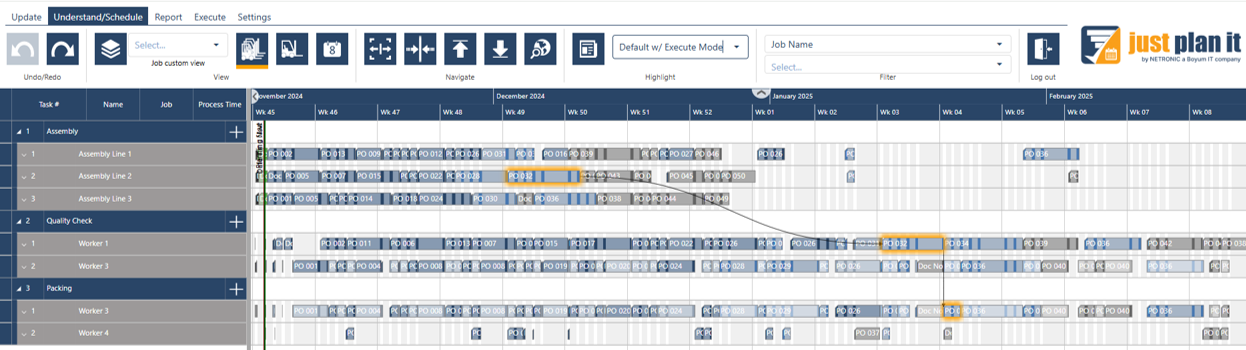

    ASAP+ starts with forward scheduling from the earliest permitted start. A backward pass then refines the job’s timing, which can move earlier operations closer to the downstream work they support.

    JIT+ starts with backward scheduling from the due date. An additional forward pass refines timing in the other direction.

    Both strategies aim to tighten the flow of work within the modeled constraints. The result depends on the production situation; neither strategy removes a bottleneck or guarantees a globally optimal schedule.





    Review the effect around a bottleneck

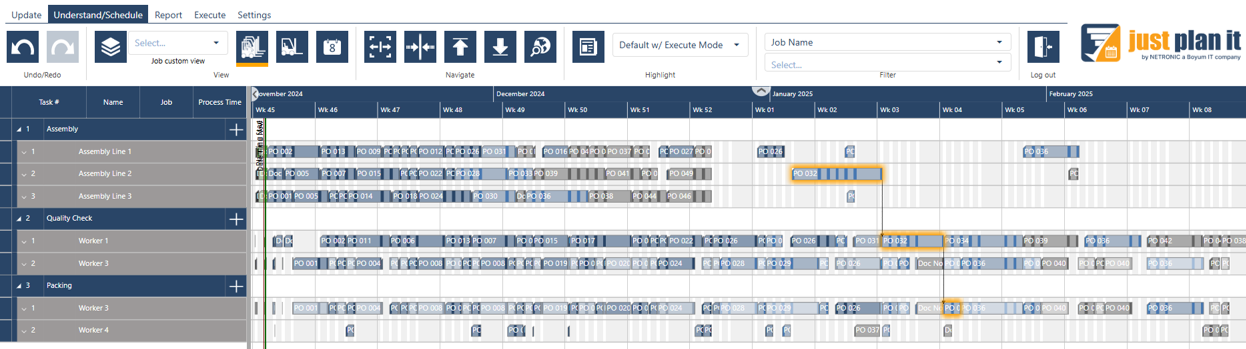

    Consider a job with assembly followed by quality inspection. If inspection is heavily loaded, completing assembly early may create a long waiting period.

    An extended strategy can move assembly closer to the inspection slot where the schedule permits. This can shorten the job’s planned time in production and reduce unnecessary work in progress without requiring inspection to run earlier.

    Shortening the time between a job’s first and last operations does not increase the inspection resource’s capacity. It helps coordinate upstream work with the capacity already available.





    Choose between individual jobs and a global setting

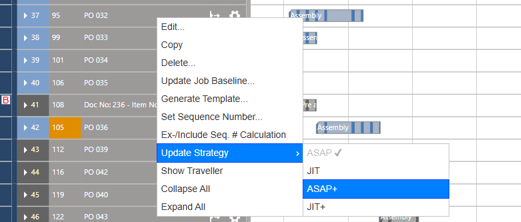

    Planners can select ASAP+ or JIT+ for individual jobs or through a global setting. Testing representative jobs first helps the team understand the effect before applying a strategy more widely.

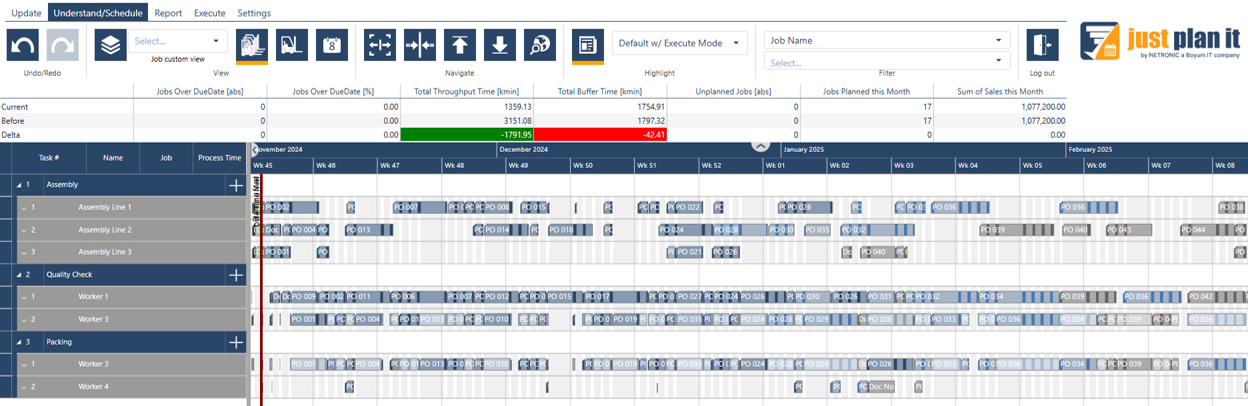

    A tighter schedule may reduce some of the buffer available to absorb disruption. Additional calculation passes may also increase recalculation time, particularly in larger schedules.

    Planners should compare completion dates, waiting time, delivery margin, and calculation responsiveness before changing the global strategy. Where only a few jobs pass through a significant bottleneck, selective use may be more appropriate.





    Use wildcard patterns to refine views

    Filters and color schemes help planners focus on relevant parts of the schedule. The “like” comparator supports flexible pattern matching, using “?” to represent exactly one character and “*” to represent zero or more characters.

    For example, “a?c” can match “abc” but not “ac”, while “a*c” can match both. Multiple wildcards can be used within one pattern.

    Teams should test patterns against representative values to confirm that the resulting view includes the intended jobs or resources.





    Visual job shop scheduling cheat sheetCompare strategies against the production objective

    Just Plan It supports four scheduling strategies: ASAP, JIT, ASAP+, and JIT+. The appropriate choice depends on the workload, resource constraints, and balance between reducing waiting time and preserving delivery margin.

    A controlled comparison gives planners a practical basis for that decision. Reviewing the results against actual production conditions helps the team choose where an extended strategy adds value.
