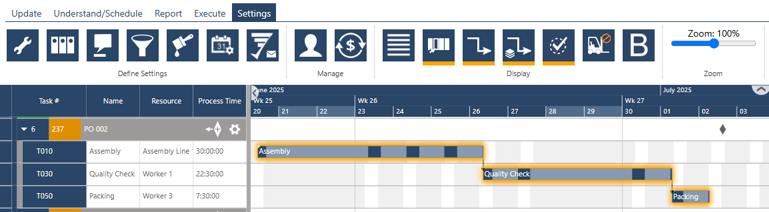

Backward scheduling works from a required completion date to determine when preceding operations should run. It can help avoid releasing work earlier than necessary, but a plan with little delivery margin may be sensitive to disruption.
The Just Plan It Q2 2025 release, described in July 2025, added a configurable buffer for backward-scheduled jobs and direct access to hyperlinks from task tooltips.

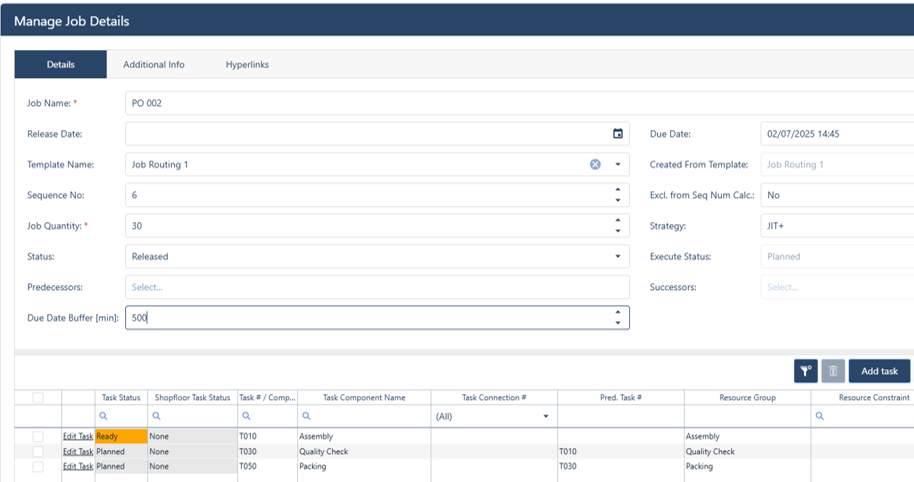

For jobs using JIT or JIT+, the documented release allowed a due date buffer to be entered in the Manage Job Details dialog. The scheduling engine deducted that duration from the due date when calculating the backward schedule.
This creates an earlier internal scheduling target while retaining the job’s due date. It does not add production capacity or guarantee that the resulting target can be met.
Planners should choose buffers using relevant production experience, including variability in processing, queues, and external dependencies. A buffer should be reviewed as conditions change rather than treated as a permanent default for every type of work.
The release description specifies that the buffer deduction uses a 24/7 calendar, rather than the working calendars of individual resources. This makes the time of day on the due date important.
For example, a 24-hour buffer deducted from Monday at 4 p.m. produces an internal target of Sunday at 4 p.m. That is an elapsed-time calculation; it does not create Sunday working capacity. Resource calendars still need to be considered when operations are scheduled.
Teams should therefore test buffers around weekends and other nonworking periods. The intended delivery margin should be visible in the result, rather than inferred from the entered duration alone.
Larger buffers may bring work forward and increase the amount of unfinished production in the system. Smaller buffers may leave less room to absorb variability.
The useful balance depends on the process, the reliability of its inputs, and the consequences of a late job. Planners should compare the effect on job completion, resource demand, and work in progress before applying a buffer more widely.

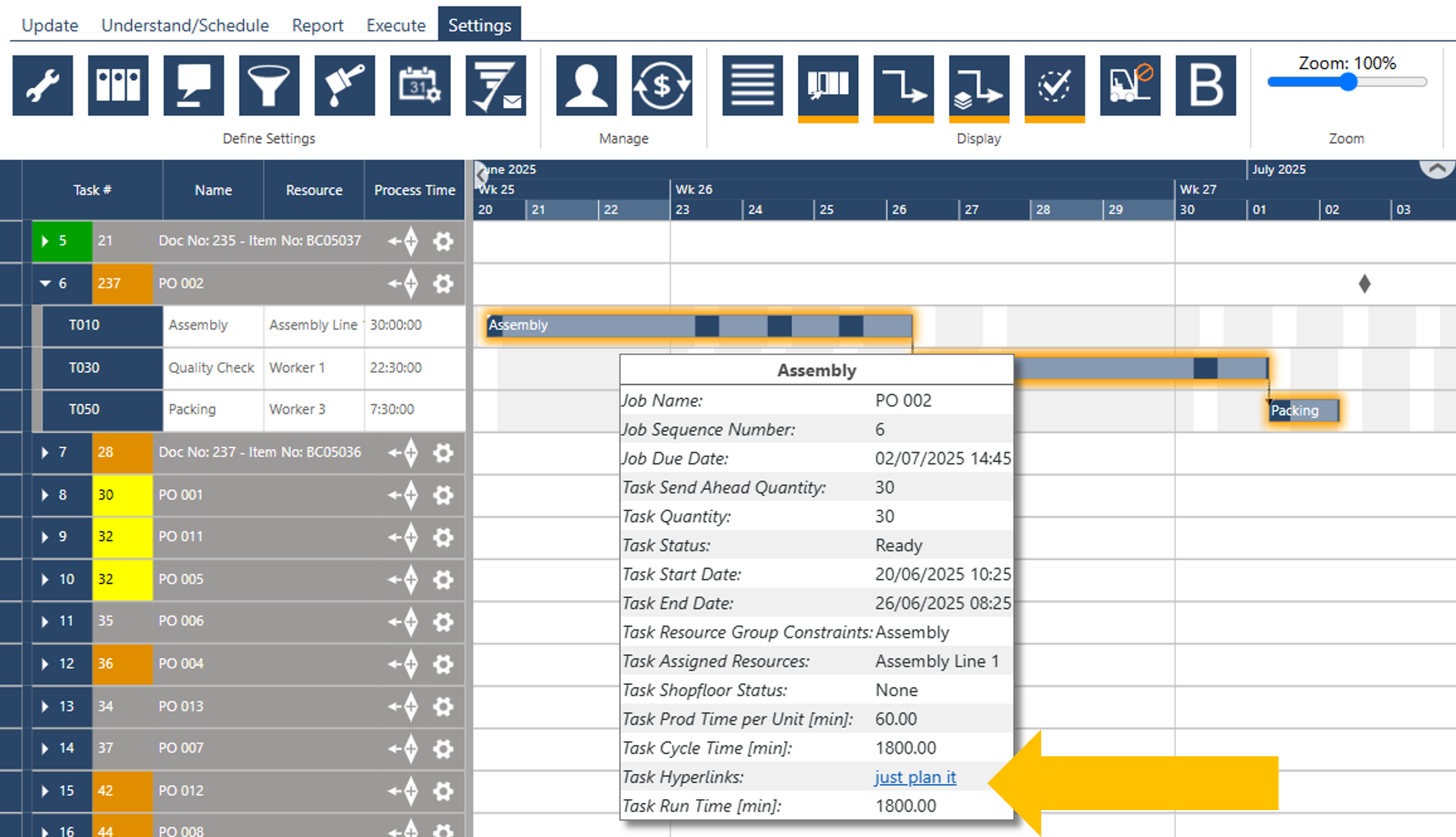

The same release made task-tooltip hyperlinks directly accessible. The documented workflow was to add a link in Manage Task Details and include the hyperlink field in the task-tooltip settings.
Users could then move the cursor to the tooltip and open the link. This reduced the steps needed to reach an associated document or other linked information.
Access still depends on the permissions of the destination system. Teams should maintain the links and confirm that the intended users can open the relevant information. Before publishing detailed instructions, the field labels and tooltip behavior should be checked in the current application.
See what Just Plan It can do for your productionA scheduling specialist will walk you through Just Plan It with your specific production environment in mind. Personalized, no pressure, 30 minutes.
These Stories on Product news
Stay in the loop for the latest product, sales and marketing updates.
© 2026 Boyum IT Solutions. All rights reserved Read our Privacy Policy & Terms of Service
